Allegheny Valley Expressway
Alexander H. Lindsay Highway
In 1910, when there were hardly enough cars to warrant a high-capacity highway, a Pittsburgh transportation plan gave birth to this expressway. The plan recommended widening and paving East Ohio Street from the North Side through Millvale, Etna, Sharpsburg, and Aspinwall. Work did not begin until 1921, which involved moving St. Nicholas Roman Catholic Church farther back onto a new foundation. In 1939, another transportation plan recommended construction of the Etna-Sharpsburg Bypass to "urban freeway standards." It would not open to traffic until 1957. Also in that same year, construction began from East Ohio Street to Blawnox.
In 1963, this section opened to traffic from PA 8 north to the Highland Park Bridge interchange and the following year to Blawnox.

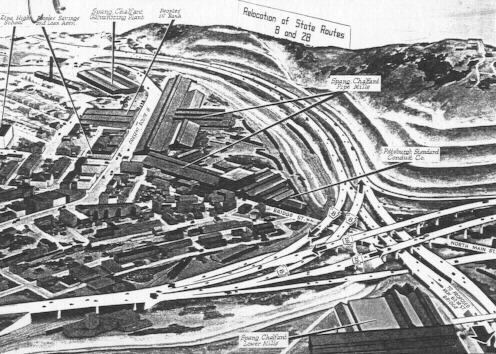

Drawing of proposed PA 28/PA 8 interchange in Etna from 1952.
(Paul Slantis)
Also in 1963, the Pittsburgh Area Transportation Plan recommended upgrading PA 28 and then PA 8, to a six-lane, limited-access highway starting 2,200 feet west of the 31st Street Bridge and ending at the 40th Street Bridge. Full interchanges would be constructed at both bridges; however, this recommendation was not carried out. It also laid out a plan that would turn PA 28 into an expressway from Pittsburgh to Brookville, this too was not carried out.
In 1968, construction began on the section from Blawnox to PA 910. The expressway was proposed from that point to the Butler County line. Construction also began on the section from Slate Lick to near Center Hill in the same year. In 1969, construction commenced on the section from PA 910 to Exit 12 and from Exit 16 to PA 356 and the Armstrong County line.
The start of the 1970s saw the construction extend from Exit 16 all the way to a new expressway alignment for US 422, also under construction, near West Kittanning. In 1971, construction commenced on the section from Exit 15 to Exit 16. In 1972, the expressway opened to traffic from Blawnox to PA 910 and from Exit 15 to US 422. However, PA 28's designation was not placed on the section from Exit 15 to Exit 16. The following year, the expressway opened from PA 910 to Exit 12. In 1975, construction commenced on the section from Exit 12 to north of Tarentum; and during the following year, the construction was extended to Exit 15. In 1978, the PA 28 designation was routed onto the newly opened highway from Exit 11 to Exit 12 and from Exit 15 to Exit 16. The PA 28 designation still followed Freeport Road to connect between Exit 12 and Exit 15.
In 1980, the expressway opened from Exit 12 to Exit 13 and that designation was moved onto this section. In 1984, a "Priority Highway System Plan" was proposed by the Southwestern Regional Planning Commission. It called for building an interchange "with Route 28 depressed below the 31st Street Bridge," and the permanent closing of Rialto Street. However, this plan was ignored just as it had been when first proposed in 1963. Even with the recommendation being turned down, it was time to celebrate the opening of the final section between Exit 13 and Exit 15 in 1985.
The first section of the expressway to see a rehabilitation was the infamous "death stretch" that extended from Millvale to Etna. Statistics showed that this section saw 169 accidents occurred from 1982 through 1987. Ninety-six of them involved injuries and four involved one or more fatalities. Construction began on September 6, 1988, and involved blasting 600,000 cubic yards of rock from the hillside that parallels the highway to reduce slides, widening the lanes to 12 feet each, adding 10-foot-wide shoulders, adding should pull-off areas such as on the Parkway East, and placing a Jersey barrier in the middle of the four foot median. The Etna interchange received new lights and signage. The $14.4 million project that required four lanes of traffic to squeeze into two finally came to an end December 7, 1990, due to rain hampering construction. Glare screen was erected on the Jersey barrier in 1991 to cut down on the effects of headlights from oncoming traffic. One final touch to this section was the addition of lighting. A little unconventional due to the placement in the median instead of the outside due to the narrow right-of-way, the lights came on-line in 1995. The conduit and foundations had been installed during the rehabilitation project. The standards were not installed then because of financial limitations and uncertainty over who would pay for the electric bill.
In 1994, the year's Long Range Transportation Plan proposed widening the highway to 54 feet between Troy Hill Road and the 40th Street Bridge. State representative Don Walko commented on the lackluster performance of accomplishing this task by saying, "It's a failure of leadership going back many years. By completing other parts of the expressway northeast of the city and the interstates [I-279 and I-579] without dealing with tough issues on Route 28, we've created the missing link, a terrible bottleneck."
With all of the improvements there remains a two-mile section from the Heinz plant to the 40th Street Bridge which is a thorn in the side of many drivers, earning the name "missing link." If PennDOT and the politicians do not work together this time to get the project completed, engineers warn that traffic around the 31st Street Bridge will increase to 90,000 vehicles a day. Speed will drop to an incredible one mile an hour by 2020, which is a snail's pace by any urban standard.
Many people ask, "So what is taking forever to get this done?" The answer to that question is answered by Troy Hill Citizens, Inc. chair Cecelia Gavran. "Every time a politician comes up with another priority, money set aside for Route 28 goes somewhere else. We don't have a [Kevin] McClatchy or a [Dan] Rooney to help us. It's not what you know, it's who you know."
If anyone knows the value of this project, it is the residents who call Troy Hill home. The neighborhood sits on a hilltop across from the PA 28/31st Street Bridge intersection. It is the confluence where too much traffic and too little "green time" to go around on the signals causes 60,000 to 70,000 vehicles to idle a day at the intersection. Gavran went on to say, "The bureaucrats say 'stadium' and one year later we see a stadium going up. They re-examine and re-examine Route 28, but nothing gets done. It's a project that politicians kick around. Now they tell us we'll see action within three years. If we do, I'll eat a copy of the Sunday P-G."
A cardboard box filled with paperwork at the PennDOT District 11 office in Bridgeville leads Gavran to believe she will never see construction crews rebuilding PA 28. While there have been plans on the drawing board in the past, nothing has been done with them. PennDOT officials say that plans are on track to widen PA 28 and replace the signalized intersections at the 31st Street and 40th Street Bridges with grade-separated interchanges.
Other characteristics of the highway are narrow lanes, speeding, congestion, no shoulders, and poor lighting, which resemble the infamous "death stretch" from Millvale to Etna where 26 fatal accidents occurred in as many years. In the section under study, there have been 198 accidents between 1991 and 1995, which is more than double the state average. Out of those 198, five resulted in fatalities.
Bill Gibson, the PennDOT engineer overseeing the PA 28 progress, provides hope that the project will be completed this time around. "We're in step six of a ten-step, federally mandated process leading to project approval," said Gibson. "We're working in a very tight corridor, with the river and the railroad on one side, the hillside on the other side and numerous historical, environmental and relocation questions to address." The $110 million project included the following aspects:
Work was projected to begin late in 2004, and consisted of nine phases in order to maintain two lanes of traffic in both directions. The new expressway was expected to open in mid-2009, but the plan was shelved.
A major project that got underway in 2001 was the resurfacing of the highway between Exit 6 and Exit 10. The $13 million project started on March 12, 2001, and entailed patching potholes and laying new concrete. The first rush hour had traffic crawling along at five to ten miles an hour, with backups from two miles south of the Highland Park Bridge to R.I.D.C Park. Some drivers honked their horns and banged on steering wheels. One driver even threw an apple core at an orange construction barrel. The $12.5 million project concluded on September 20, 2001.
Another project that has been going on at the same time is the reconstruction of the PA 28/PA 8 interchange. When originally built, the overpasses for the Allegheny Valley Expressway were built for only one lane of travel. On August 16, 1999, the off-ramp to PA 8 northbound from PA 28 southbound was closed to rebuild it for a total of $4.7 million. The ramp was lengthened and the hillside next to it was excavated to lessen the threat of falling rocks. The ramp reopened on January 11, 2000.
The next step of the project was the demolition of the PA 28 southbound overpass and the widening the support pillars for a two-lane wide ramp which started on April 10, 2001, was scheduled to be completed by Thanksgiving 2001. However, the company supplying the steel for the bridge deck went bankrupt and forced the contractor to find another source. The new $11.5 million southbound bridge opened to traffic on December 10, 2001.
Since Saint Nicholas Church is a major stumbling block for upgrading East Ohio Street to an expressway, new plans were laid out on July 14, 2003. The new PA 28 would be an elevated, six-lane expressway about 30 feet above the current alignment. A modification to this plan would rebuild the current roadway, impose a speed limit of 40 MPH, and give the church a five-foot-wide sidewalk in the front. Both plans would include diamond interchanges at the 31st Street and 40th Street Bridges. "If the 31st Street and 40th Street bridges weren't there, this would be a piece of cake," PennDOT Planning Engineer Todd Kravits said. Price tag for this project would range from $160 million to $200 million and would not start before 2008. A separate project to eliminate traffic lights between Chestnut and East Streets is not factored into this estimate. Both plans have the same guidelines:
His plan had the northbound lanes being built over the Norfolk Southern Railroad tracks, which parallel East Ohio Street, and retaining a section of the street for local access. Dr. White said, "PennDOT's bulldozer solution does not make sense. The air rights over the tracks present a handsome opportunity for an elevated highway that solves all of the problems of Route 28 without an ugly, two-mile retaining wall, undercutting foundations and taking the church." PennDOT engineers said of the proposal that "bubbling out" the northbound lanes where he suggested would tack on an additional $40 million.
Rock falls are still a problem for the expressway between the RIDC Park and Harmar interchanges. On July 24, 2003, an estimated 400 tons of rock and debris fell from the infamous cliff and onto PA 28, causing PennDOT to reduce the roadway to one lane southbound. The only thing that can be done is create a "drop zone," where it can fall safely to the ground. Other proposals, such as installing chain-link fencing to hold back the debris, has been dismissed as impractical or too expensive.
The next chapter in the saga of the PA 8 interchange reconstruction began on April 26, 2004. Just as commuters were getting used to not seeing construction on the expressway, PennDOT continued its improvements. The through lanes of the Allegheny Valley Expressway were rebuilt and the ramp from PA 8 south was realigned. The $26.5 million project finished on March 17, 2005. Before that began, a water line had to be relocated and a 1,000-foot-long retaining wall be built below the PA 28 grade. For a recap of the construction, and future construction, see the PA 28/PA 8 Interchange Reconstruction page.
In the never ending saga of what to do with the at-grade section of East Ohio Street, more alternatives are announced on June 11, 2004. The new Alternate 6M was introduced, which incorporates an urban-type boulevard at the North Side end and limited-access features at the 31st and 40th Street Bridges in the form of interchanges and ten foot shoulders. Rialto Street would stay but Millvale Industrial Park would go, but Millvale would get better access and a riverfront park. Twenty-four businesses and 95 residences would be acquired, eight historic properties including the embattled Saint Nicholas Church would have to be mitigated, and approximately 2,700 feet of Norfolk Southern Railway track would be relocated. Alternative 6 would avoid the church and reduce the number of high retaining walls which would be textured to look like brick or stone, but only provide 2 1/2-foot-wide shoulders and a 30 MPH speed limit. The final plan, Alternative 2, would eliminate the church and require retaining walls up to 65 feet high. However, 10-foot-wide shoulders, interchanges at the two bridges, and provide a speed limit of 45 MPH. The Alternate 6M would incorporate Alternative 6 from the Heinz Plant to Saint Nicholas Church and then transition to Alternative 2 to Millvale. PennDOT has proposed an observation deck along Eggers Street in Troy Hill where homes would have to be acquired. Final design and acquisitions would take place in 2008. For more on this, see the SR 0028-East Ohio Street Improvement Project site.
What is another year without another PA 28 rebuilding plan? The new 2006 plan calls for shifting the Norfolk Southern tracks towards the Allegheny River rather than cutting into the hillside. Eighty-one residences and eight commercial properties would be displaced, but the status of the Millvale Industrial Park is still undecided. Final cost of the project would be between $120 and $130 million, $60 million less than earlier proposals, and if PennDOT can covered a $40 to $50 million funding gap, right-of-way acquisition would be completed in 2008 and construction begin a year later. The estimated length of construction would be two years. The new four-lane expressway would follow the same route as East Ohio Street with a posted speed limit of 45 MPH. An interchange would be built at the 31st Street Bridge intersection; however, northbound traffic would no longer access Rialto Street, but traffic from there could go in either direction on PA 28. A full interchange would be built at the 40th Street Bridge. A Jersey barrier would be added to separate the flow of traffic and protect pedestrians. The most favorable aspect of the project is that it will save Saint Nicholas Church, which will be accessible southbound via a ramp. Rush hours will also be reduced from an average of 14 minutes at 10 MPH over just two miles to three minutes at 40 MPH.
Landslides aren't anything new to the southbound lanes of the expressway between Exit 10 and Exit 11, but a new location was affected on March 22, 2007. Recent heavy rains had caused the hillside along the southbound lanes between Exit 5 and Exit 6 to become unstable with an estimated 1,000 cubic yards of material falling onto the expressway. The northbound lanes were closed for awhile but they were quickly cleared and reopened. PennDOT hired a contractor to remove debris and create a drop zone along the shoulder to catch any addition debris, install a protective barrier, and replace damaged guide rails. The work was to conclude by Monday morning rush hour but the crews managed to finish a day early.
|
In the 1963 Pittsburgh Area Transportation Plan, provisions were made to build this expressway all the way to the then proposed Interstate 80 near Brookville. Aside from the grading that took place at the former end at Kittanning, no other work was ever performed on this cancelled section and the plan axed in the 1970s. Interchanges would have been built at the following locations:
There have been reports that PennDOT is interesting in studying an extension to I-80, and it made the 2015 Long Range Transportation Plan. The Allegheny Valley Expressway Extension would be a four-lane expressway extending 17.5 miles to financed and built by the Pennsylvania Turnpike Commission. This extension is listed under Subsequent Extension Authorizations in the Pennsylvania Turnpike section of Pennsylvania Statutes. If built, this would become PA Turnpike 28. |
